Overview & Context
OverviewBuilding a new custom home, duplex, laneway house, or multiplex in British Columbia is subject to the most thorough inspection regime in Canadian residential construction. Every structural element, plumbing run, air barrier seal, and safety fixture must be inspected and stamped before it can be legally closed in.
Prematurely covering uninspected work is a major building code violation that can result in immediate stop-work orders and costly uncovering mandates. Here is the full guide to passing your new build inspections on the first attempt.
Step 1: Groundwork, Footings & BCLS Foundation Survey

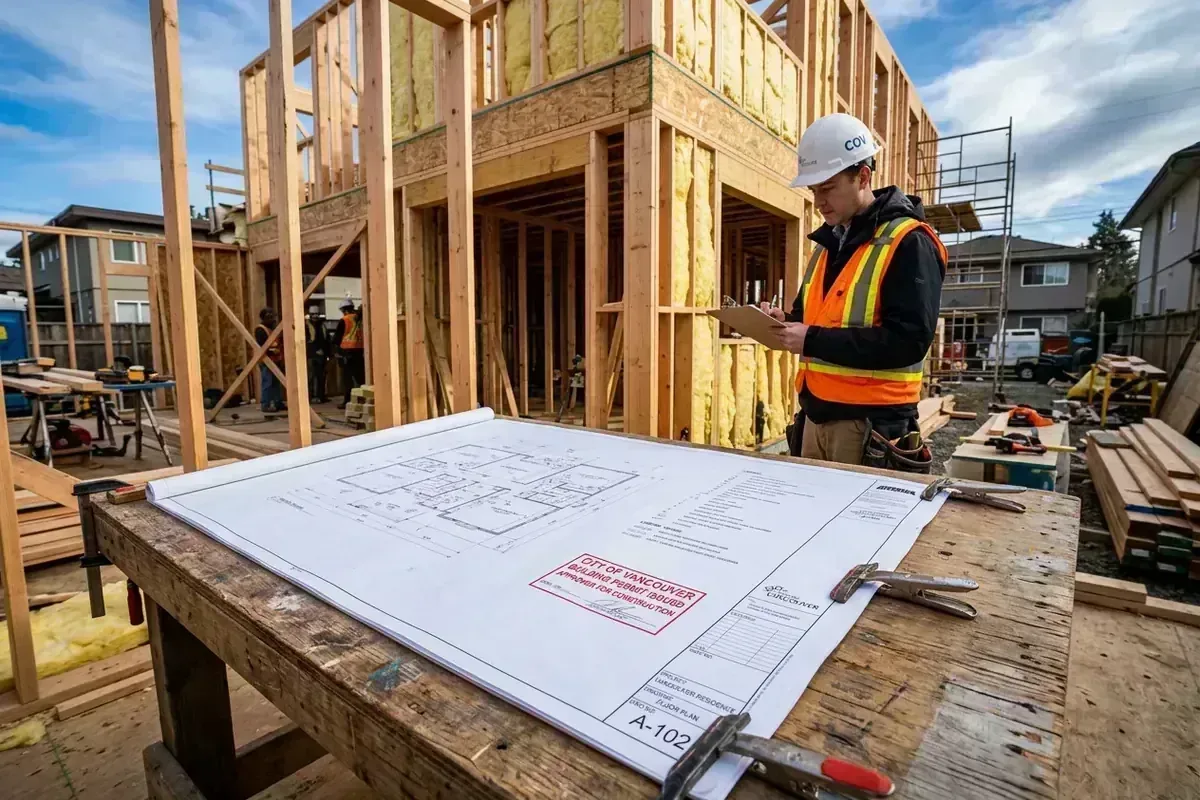

Phase 01Before calling any inspection, you must have the official city-stamped paper drawing set printed in full size (24″ × 36″ or 30″ × 42″) and placed in a weatherproof plan box or table on site.
- Excavation Inspection: Confirms bearing soil capacity and excavation depth before forms are placed.
- Footing Forms & Rebar: Verifies footing dimensions, rebar sizes, keyways, and soil clearances before pouring concrete footings.
- Foundation Forms & BCLS Survey: Verifies wall forms, anchor bolts, and includes submitting a certified BCLS Building Location Survey from a registered BC Land Surveyor proving the foundation matches approved property line setbacks.
- Perimeter Drain Tile & Damp-Proofing: Confirms 4″ perforated drain tile slope, washed rock bedding, and foundation damp-proofing before backfilling.
Step 2: Under-Slab Plumbing & Perimeter Drainage
Phase 02The under-slab and perimeter drainage inspections protect your home's foundation from moisture ingress, hydrostatic groundwater pressure, and radon soil gas before backfill and slabs are poured:
- Under-Slab Rough-In: Examines DWV plumbing lines under hydrostatic water pressure head test to ensure zero joint leakage.

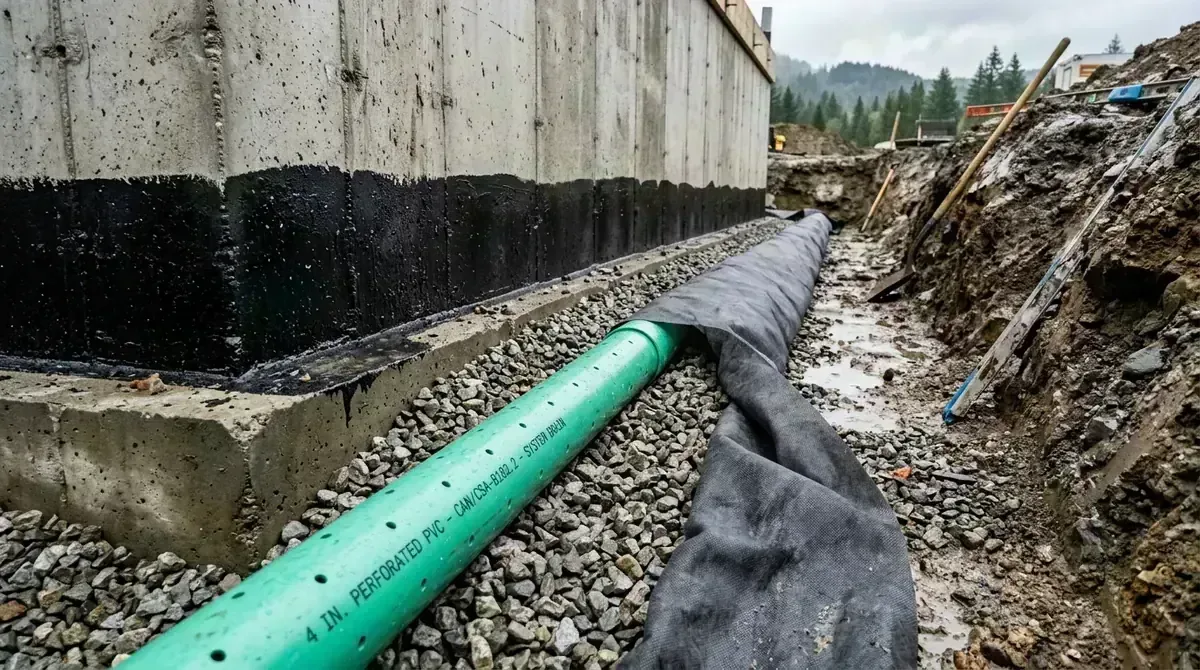

- Perimeter Drain Tile & Damp-Proofing: 4″ perforated drain pipe laid with washed crushed rock bedding, foundation membrane damp-proofing, and gravity connection to municipal storm sewers.
- Vapour Barrier & Insulation: Verifies continuous 6-mil polyethylene ground cover, taped laps, sub-slab rigid foam insulation, and radon soil gas collection rough-in pipes.
Step 3: Exterior Envelope, Sheathing & Rain Screen Mockup
Phase 03British Columbia's wet coastal climate mandates rigorous building envelope moisture management:
- Sheathing & Shear Walls: Verifies plywood/OSB fastening patterns (6″ edge / 12″ field) and engineered hold-down anchors.
- Rain Screen Drainage Plane: Verifies 10mm cavity strapping, base bug screens, window sill pan flashings, and self-adhered membrane wraps before installing siding, brick, or stucco.
Step 4: Rough-In Trades, Framing & Mid-Blower Door Test
Phase 04Rough-in trades (plumbing, gas, HVAC, electrical) must be fully inspected and approved before the framing inspection. Once approved, the municipal framing inspector reviews:

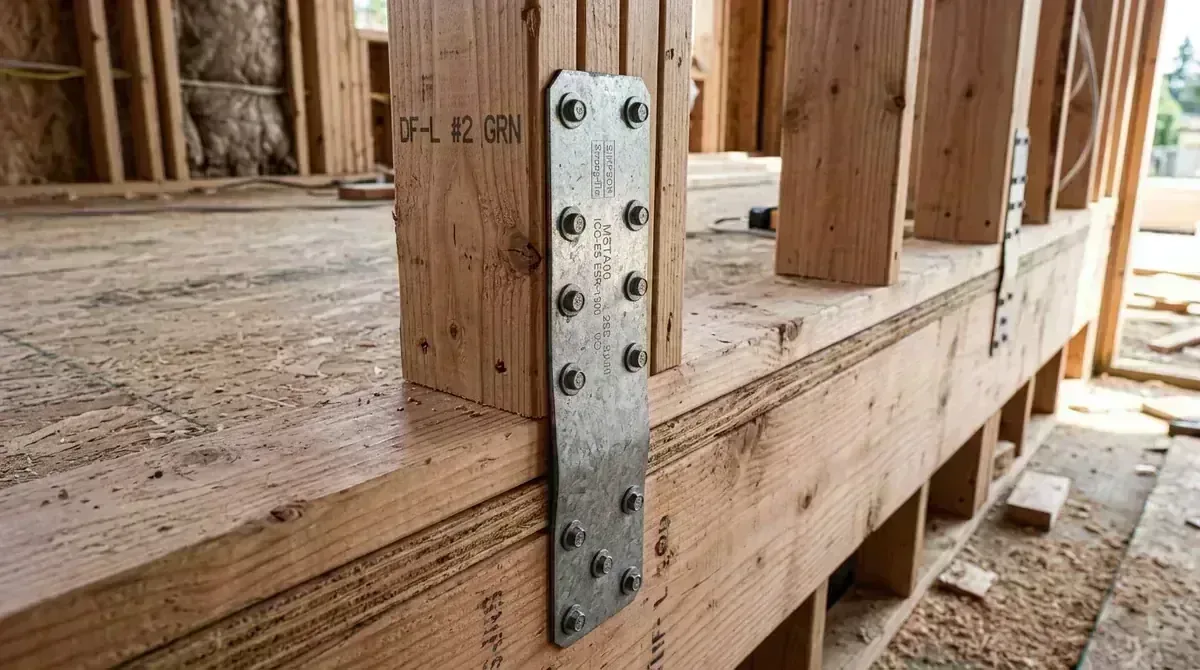

- Framing Inspection: Examines all load-bearing studs, engineered floor joists, point load transfers, headers, fire stops, and structural hold-downs against the approved building permit plans.

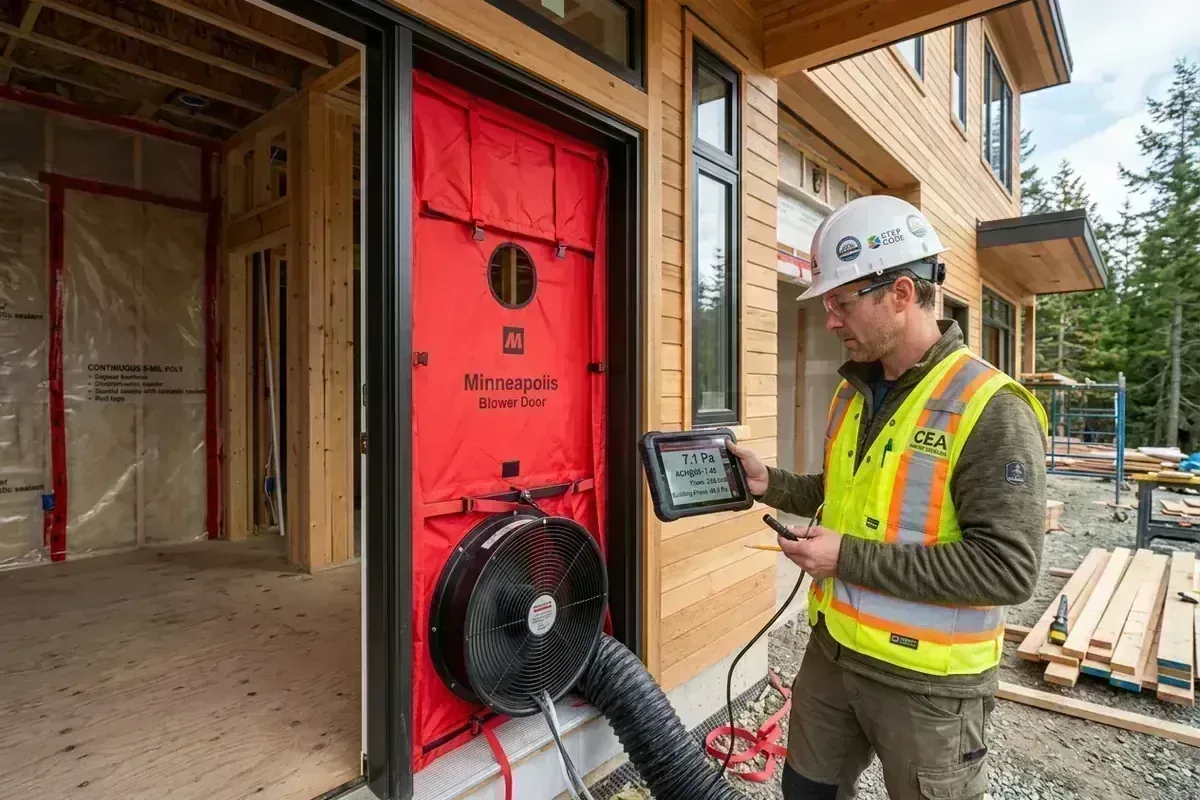

- Mid-Construction Step Code Test: Certified Energy Advisors (CEAs) perform an airtightness blower door test to catch building envelope air leaks before insulating.
Step 5: Insulation, Fire Drywall, Final Tests & Occupancy
Phase 05The final milestone stages transition the building from active construction to lawful occupancy:
- Insulation & Poly: R-values checked (R-22+ walls, R-50+ ceilings) and continuous 6-mil poly sealed with acoustical sealant.
- Fire Drywall: 5/8″ Type X drywall between secondary suites or garage walls inspected before taping and mudding.
- Final Trade Inspections: Final plumbing, electrical, and gas passes are issued.
- Final Building Sign-Off: Smoke/CO alarms tested, stair handrails verified, exterior grading confirmed, leading to the issuance of the Occupancy Certificate.
Related Inspection Guides & Resources
Resources- Master Permit Review Process: Complete 8-Step BC Permit Approval Lifecycle
- Renovation Inspections: Home Renovation & Addition Inspections Guide
- Commercial Inspections: Commercial Tenant Improvement Inspections Guide
- Book Your Project Consultation: Contact Canadian Blueprint →
Canadian Blueprint Inc.
BC Building Design & Permit Drawings
Published • Updated
